For nearly two decades, the Virginia Railway Express (VRE), CSX Transportation, Amtrak and the Commonwealth of Virginia envisioned a modernized Quantico Station that could safely and reliably serve the region’s growing passenger and freight rail needs. In 2025, that vision became a reality with the completion of the Quantico Station Improvements Project. This milestone transformed one of the most complex and constrained corridors in the Mid-Atlantic.
Alongside our client, Dallas Richards, PE, Deputy CEO and Chief Engineer at VRE, I recently had the privilege of presenting this project at the 2025 AREMA National Conference, where it was highlighted as a model of collaboration, technical innovation and stakeholder coordination.
As engineer-of-record, STV is proud to have played a central role in this achievement. Our team has supported the development of this corridor for decades. In 2007, we provided design and construction management for a new 35-span, two-track bridge over Quantico Creek – engineered to eventually carry a third mainline track. We later delivered preliminary engineering and environmental services for the Arkendale to Powells Creek Third Track Project, building on that foundation. This continuity reflects STV’s enduring commitment to Virginia’s passenger rail network and to the communities it serves.
Why Quantico Station is Unlike Any Other in the U.S.
Quantico Station is uniquely situated. The facility is surrounded by Marine Corps Base Quantico, making it the only public station in the country accessible solely by rail. This context posed significant logistical challenges – from security requirements for every delivery to maintaining uninterrupted rail operations through a highly constrained site. At the same time, the design had to honor the historic character of the existing station while anticipating future growth, including the potential for a fourth mainline track.

How Ridership Drove Quantico Station’s Modernization
The case for modernizing Quantico Station was clear. Today, the Fredericksburg Line handles nearly 7,800 riders each weekday, making it VRE’s busiest route and a crucial commuter connection into Washington, D.C. Systemwide, VRE serves close to 11,000 daily passengers across 19 stations – and ridership is steadily rebounding post-pandemic, rising from about 6,800 daily riders in early 2024 to over 8,000 by early 2025.
To meet this demand, Virginia advanced a $27.5 million station improvement program, tied to a broader 9.2-mile third track expansion between Arkendale and North Possum Point. Together, these projects are boosting capacity, reliability and safety for passenger and freight operations – directly addressing one of the corridor’s most significant chokepoints.

Key Design Solutions for Safety, Reliability and Access at Quantico Station
The project delivered wide-ranging improvements:
- New center platform and extended east platform – providing three boardable platform edges to increase operational flexibility for both VRE and Amtrak.

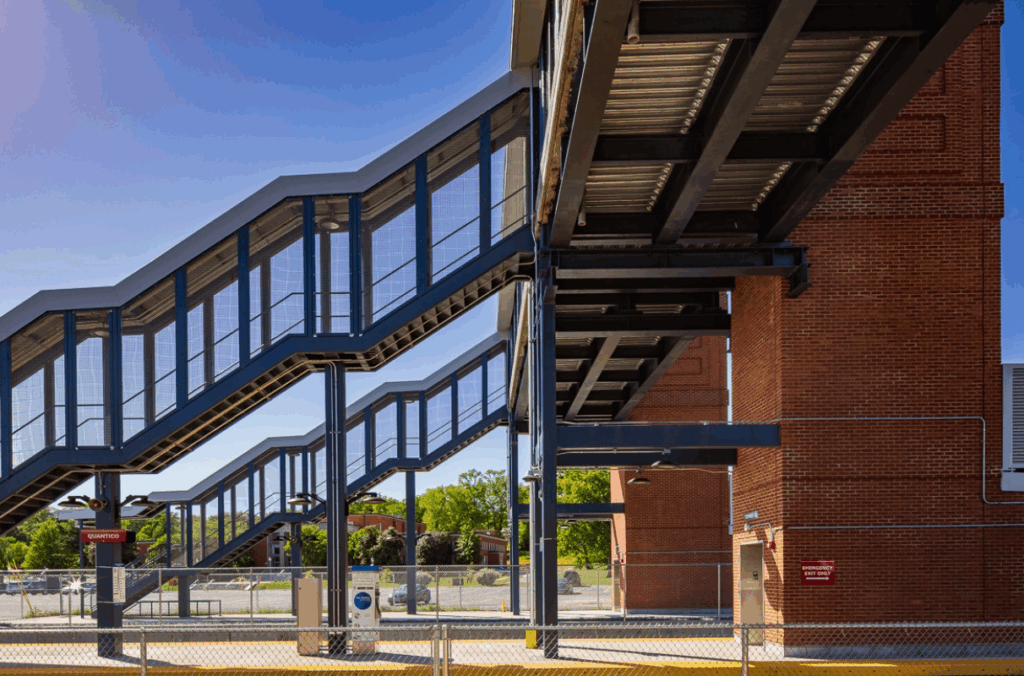

- Elevator towers and pedestrian bridges – creating safe, grade-separated access between the Town of Quantico and Marine Corps Base Quantico, with architectural features designed to complement the historic station.
- Safety upgrades at Potomac Avenue – including four-quadrant gates, enhanced signage and pavement markings at one of the region’s busiest grade crossings.
- Retaining walls and alignment shifts – minimizing impacts on the base, protecting historic structures and keeping rail service operational throughout construction.
Every decision balanced the needs of multiple stakeholders: federal, state and local agencies; the U.S. military; and the thousands of passengers and freight operators who rely on this corridor daily.

Overcoming Challenges in Delivery
No project of this scale comes without hurdles. From unexpected underground storage tanks and a World War II-era platform to Americans with Disabilities Act (ADA) refinements and coordination around a bald eagle nest, the team worked collaboratively to resolve issues without derailing schedules. Even base access presented challenges, with every material delivery and worker passing through heightened security checkpoints. These obstacles underscored the importance of proactive planning, strong communication and a flexible design-build approach.
The Long-Term Benefits of Quantico Station Improvements
The transformation of Quantico Station demonstrates a continuation of STV’s legacy of delivering resilient rail systems that serve both communities and commerce. By unlocking long-constrained capacity in the corridor, the project enhances on-time performance, increases safety and positions the Fredericksburg Line for future growth.
Looking back, it is remarkable to see how far this vision has come since completing the Quantico Creek Bridge in 2007. Today, Quantico Station stands as a testament to what long-term partnership, technical excellence, and shared commitment can achieve.
